LoomOS
Factory operating system with a dual-track milestone engine and nine mandatory pre-cutting gates.

Overview
Two milestone tracks run against every order. Track A is computed backward from the customer date and is always present, because arithmetic never fails to produce an answer. Track B fires only when a real event lands — a warehouse scan, a lab report, a QC tablet. An order can be perfectly on schedule in Track A and completely blocked in Track B, which is exactly what a date-only plan hides.
Specifications
USE CASE

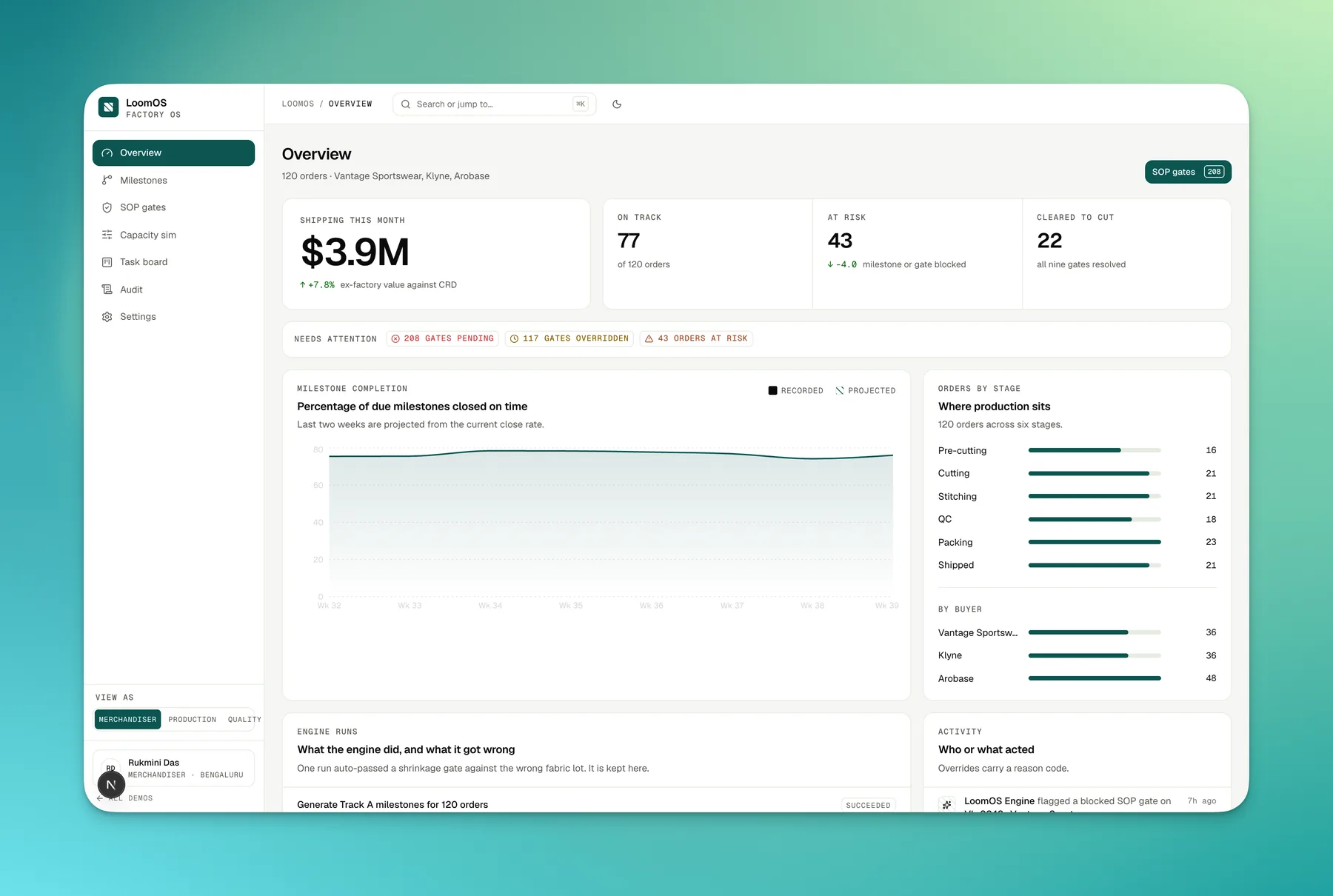

Milestone and gate control across 120 live orders
WORKFLOW
Plan, gate, cut, stitch, QC, pack, ship
OUTPUT
Dual-track milestone state plus a nine-gate cutting release
SECURITY
Gate overrides require a reason code and an approver, both logged
Features
- 01Dual-track milestones — computed dates and event-triggered facts, visually distinct
- 02Nine mandatory SOP gates that block cutting until passed or explicitly overridden
- 03Gate evidence with the file it was cleared against
- 04Every override carries a reason code, an approver and a timestamp
- 05Capacity simulator with production-day maths shown on screen
Architecture
LOOMOS PIPELINE
────────────────────────────────────────────
┌─────────────────────────┐
│ Orders + customer dates │
└─────────────────────────┘
↓
╭┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈╮
┊ Track A backward planner ┊
╰┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈╯
↓
╭┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈╮
┊ Track B event listener ┊
╰┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈╯
↓
╭┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈╮
┊ SOP gate engine — 9 gates ┊
╰┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈┈╯
↓
┌─────────┐ ┌───────────┐ ┌────┐ ┌─────────┐
│ Cutting │ │ Stitching │ │ QC │ │ Packing │
└─────────┘ └───────────┘ └────┘ └─────────┘
↓
┌───────────────────────┐
│ Live production board │
└───────────────────────┘
╭┈┈╮ dashed = model step ┌──┐ deterministic stepWhat it will not do
Every screen carries one honest failure record with its recovery path. This is the one buyers remember. A run auto-passed a shrinkage gate because a lab report existed — the report was for a different fabric lot from the same supplier. Gate evidence is now matched on lot number and cutting was held for eleven hours. A second run declined to fire a Track B milestone from a warehouse scan covering 61% of the PO; a partial receipt is not the event, so the order stayed visibly blocked rather than appearing ready to cut.
